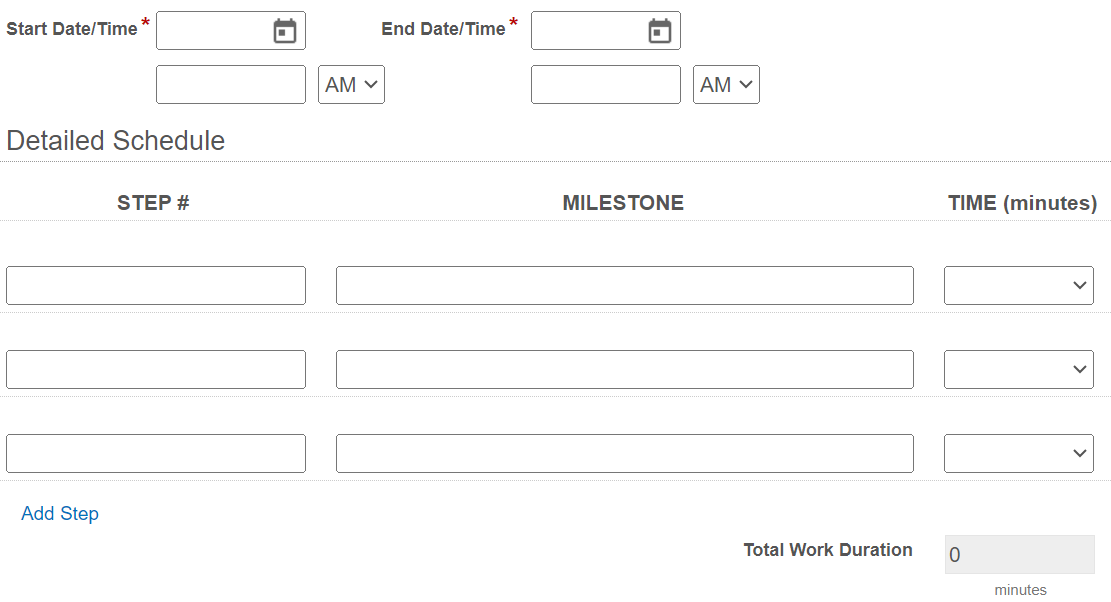

Does anyone know how I can add minutes to a date/time field to have it calculate an end date/time? I have the Start Date/Time (#q26), which will be set by the user, and the Total Work Duration (#q186), which is calculated in minutes from the Time (minutes) for each step in the Detailed Schedule collection. I need to calculate the End Date/Time (#q28) by taking the Start Date/Time and adding the Total Work Duration minutes to it. Any help would be greatly appreciated as I am unable to figure out what calculation to use.
Question
Question
Replies
Try playing with this

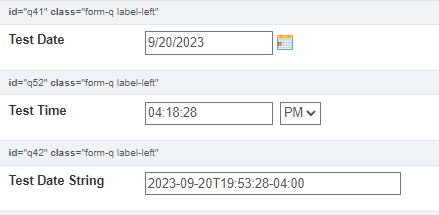

$(document).ready( function() { // let firstDate = moment().startOf('month').format().substring(0,10); // let lastDate = moment().endOf('month').format().substring(0,10); let cDate = $("#q41 input").val(); let cTime = $("#q52 input").val(); let cHalf = $("#q52 select").val(); let hMoment = moment(cDate + " " + cTime + " " + cHalf, "M/D/YYYY h:mm:ss a").add(211, "minutes").format("LLL"); let nMoment = moment().add(215, "minutes"); // $("#q42 input").val(cDate + " " + cTime + " " + cHalf); console.log(hMoment); console.log(nMoment); $("#q42 input").val(nMoment.format()); });
Check out the included library https://momentjs.com/
Hi Vanessa, when you enter the Milestone Time (Minutes) ie: 100 minutes + 80 Minutes + 500 Minutes = Total Work Duration = 680 minutes, when you add these minutes to Start Date, would these add on also be based on a day having only having 8 hours in it, and excluding weekends? Or would it just be the Start Date plus the number of minutes added to the starting time chosen by the user?
Good question Steve! It would be just the Start Date/Time
plus the number of minutes added to the starting time chosen by the user. :)
When adding days or time (hours/minutes) to a date, you have to think about hours/minutes as a fraction of a day. So if you wanted to add 90 minutes to a date, you would divide 90 mins by total number of minutes in a day (1440) and add that fraction to your date. If the number of minutes is greater than a day, the date will increment on it's own.
The formula for the End Date/Time is simply:
=SUM(StartTime,DIV(TotalWorkDuration,1440))
If you were adding hours (such as 1.5 hours), there are 24 hours in a day, so the calculation would appear as
=SUM(StartTime,DIV(TotalWorkDuration,24))
